Execution with Limited Resources: Why Delays Don’t Affect All Schedules Equally

Book a Demo

Project scheduling is often viewed through a lens of logic and order—tasks are defined, dependencies are mapped, and timelines are constructed accordingly. But in the real world, this linear perspective is rarely sufficient. One of the most underestimated elements influencing whether a project stays on track is resource availability. Most scheduling models assume that resources are readily available when tasks are ready to begin, but this is far from reality, especially in projects involving specialized skills or equipment. When only one instance of a key resource is available—like a single electrician, machine, or software expert—even a slight delay can cascade across tasks that aren’t obviously connected by logic alone. These ripple effects often go unnoticed until they’ve already impacted multiple downstream tasks, compromising the project timeline. Without a method to dynamically analyze and adjust for these constraints, project managers are often left responding reactively rather than planning proactively. This is where resource limited project management and scheduling emerges as a critical discipline—recognizing that availability, not just dependency, is what truly governs the flow of work.

This blog unpacks how limited resources can introduce hidden dependencies and unexpected delays, using a simple visual example to illustrate how these invisible constraints ripple through a project schedule. You’ll see why traditional methods of identifying schedule risk—focused solely on task dependencies—can miss the full picture when resource contention is in play. In fact, two tasks may appear to be completely unrelated in a standard dependency chart but still be in direct competition for a scarce resource. These indirect links are often the real culprits behind extended project durations and missed milestones. Understanding the dynamics of limited resources not only makes for more accurate scheduling but also better prioritization during execution. Through the following example, you’ll gain insight into how early identification of these hidden conflicts can prevent cascading delays and allow for more resilient, adaptive planning across all project phases.

What Does Resource Limited Project Management and Scheduling Look Like?

To better understand why delays don’t affect all schedules equally, let’s take a look at the following project schedule:

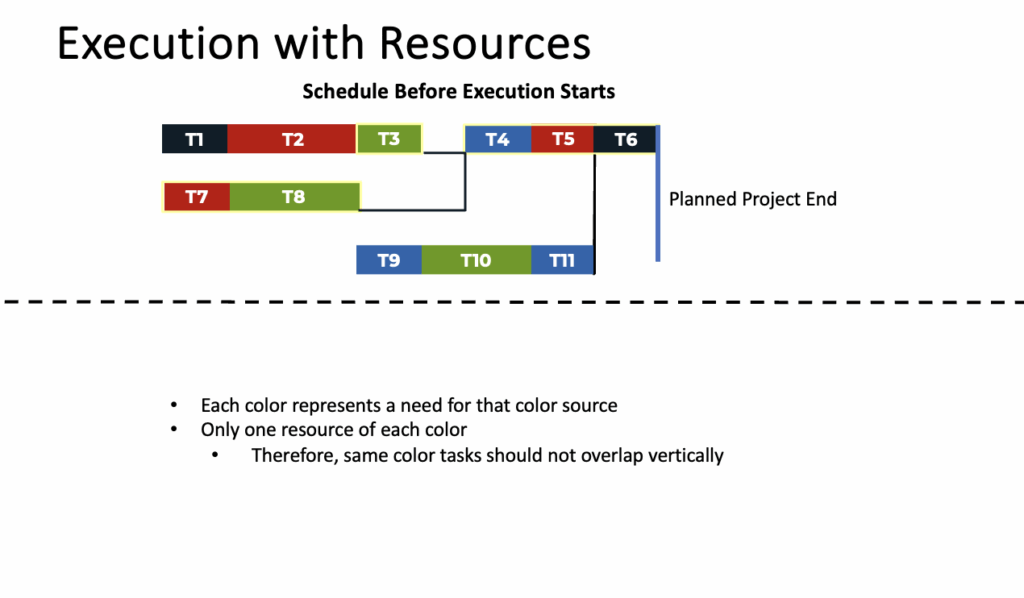

Firstly, keep in mind that each color represents a need for a specific resource of that particular color. For example, black could represent the need for a plumber while red could present the need for a mechanic, and so on.

If a task is shown before another task on the same vertical level, then they are connected by a finish-to-start link, so if a task is late, it will push the task to the right of it. Similarly, if two tasks are linked by a black line then they are also connected by a finish-to-start link.

In this example, T8 has a finish-to-start link with T4. Moreover, there is only one available resource of each color:

  • 1 black resource
  • 1 red resource
  • 1 green resource
  • 1 blue resource

As such, before the project starts and during execution of the project, looking vertically, one should not see an overlap of two colors. Look below and note that there is no vertical overlap of colors.

Now, let’s start the execution of the project.

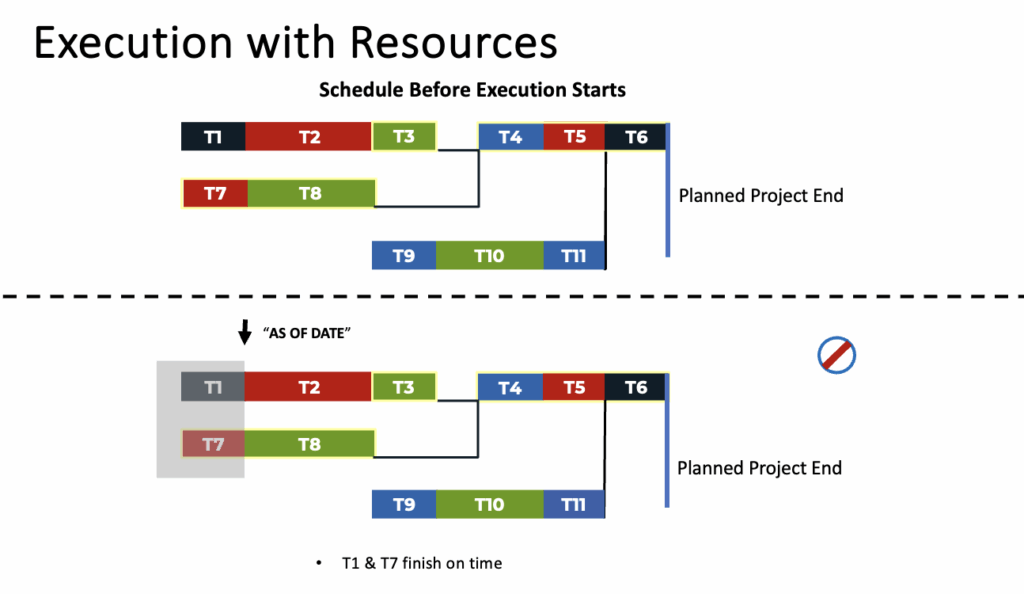

As the project progresses, both tasks T1 and T7 essentially finish on time.

In the image below, the planned project is shown above the dashed line, while below the dashed line the in-process project with the “as of date” shown at the right of the gray area shows that T1 and T7 are completed.

As the project continues, after task T8 has been worked on for a time, an update is provided that estimates the remaining duration of T8 and it is later than the original end date of T8.

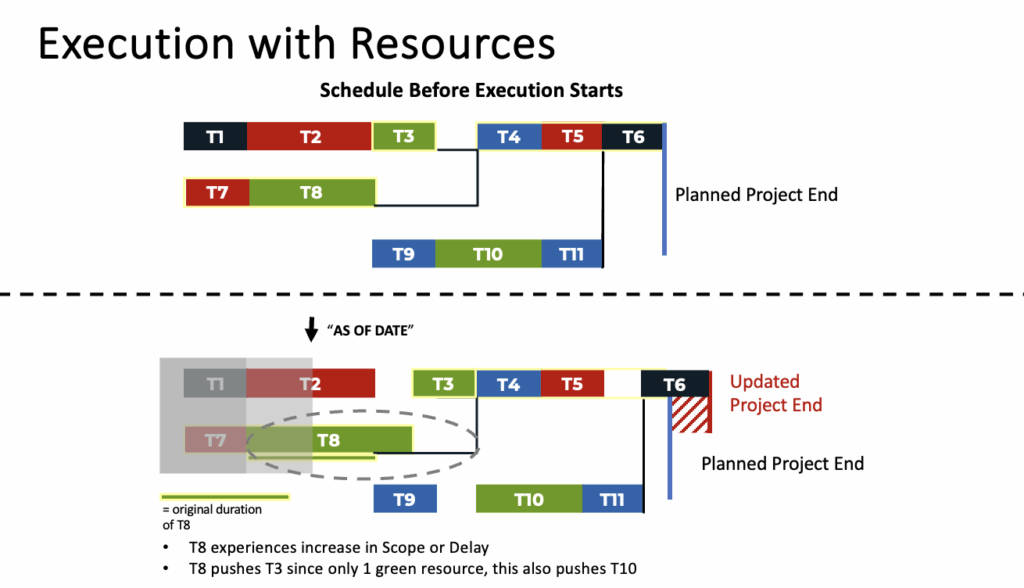

In this case, this delay pushes T3 to the right since T8 & T3 use the same resource, the original gap between T3 & T4 prevents T4 from being pushed to the right in this case. However, T3 uses the same resources as T10, thus T10 gets pushed to the right, which then pushed T11 to the right, which pushes T6 to the right, and thus pushed the project end date to the right, therefore making the project extend past the “Planned Project End” time.

Let us review:

T1 and T7 finished on time.

T8’s duration was longer than its planned duration.

  • The first portion of T8’s delay is absorbed by the gap between T3 and T4; the rest of the delay impacts T10, T11 & T6.
  • Since T6 is the last task in the project and now it is late, the project is now late.

Not that if one was not considering resource contentions, the delay in T8 would be assumed to only affect other tasks if it went so long that it pushed T4 since that is the next task connected to T8 by finish-to-start constraints, which would be completely different than what would be occurring in reality.

Conclusion

This example makes it clear that understanding task dependencies alone is not enough to create a realistic project schedule—resource constraints must be explicitly accounted for. Even though a delay in T8 did not directly push its logical successor, T4, the shared use of a limited resource caused indirect but significant downstream effects. These effects rippled through T3, T10, T11, and ultimately T6, which marked the final task of the project. This domino effect pushed the overall project end date beyond the planned deadline—despite the logical task dependencies suggesting otherwise. Such insights reveal how a seemingly minor disruption can unfold into widespread delays when resource availability is tight. It’s important to realize that delays like this can be hidden within otherwise well-structured Gantt charts and CPM networks. Only by layering resource data into the schedule view can project teams uncover these critical, resource-driven paths that operate independently of logic-based sequencing. The principles demonstrated here are central to resource limited project management and scheduling, which emphasizes proactive planning around both task flow and resource demand.

In real-world project management, this underscores the importance of moving beyond basic scheduling assumptions. Tools and methodologies that integrate resource-level constraints into the scheduling logic offer a far more accurate picture of project risk and deliverability. Ignoring resource contention leads to blind spots that traditional scheduling tools fail to capture. Project leaders and schedulers should consider using more advanced solutions—such as Aurora, a powerful scheduling system developed by Stottler Henke—that intelligently models complex resource requirements, task interdependencies, and domain-specific rules. Aurora’s decision-making engine applies sophisticated heuristics and scheduling knowledge to create optimized, real-world-ready project schedules. Its interactive graphical interface and automatic conflict detection make it especially well-suited for managing resource-constrained, high-stakes projects across industries like aerospace, manufacturing, and software development. Whether you’re managing a production line, coordinating multi-role field teams, or juggling tight timelines in software development, Aurora empowers you to schedule with clarity and confidence. After all, it’s not just what needs to be done and when, but also who or what is available to do it that truly determines whether a project finishes on time.
